Arman Malek, Emiliano Micalizio, Alexander Reinhold

March 19, 2026

Investable infrastructure

Policy-aligned, permit-certain, and performance-proven. Why policy and regulation increasingly determine the bankability of European infrastructure assets.

Electric wires and district heating tubes at sunrise

For infrastructure investors, the question of value often starts with policy and regulatory risks rather than rather than technology risks. Across Europe, investors often find that project value is shaped less by engineering fundamentals and more by regulatory alignment. Permitting delays, grid/network connection uncertainty, and evolving environmental rules have become among the most common causes of schedule overruns, capital repricing, and stranded assets in infrastructure portfolios.

For most infrastructure sectors, such as renewables, rail, digital infrastructure and energy networks, the technology risks are now relatively well understood. What is less well understood is the policy frameworks, permitting processes, and long-term compliance obligations that determine how assets perform throughout their lives.

Programmes such as the EU Recovery and Resilience Facility (RRF) accelerated infrastructure deployment by reducing financing risk and supporting project pipelines. The RRF's expiration this year will shape post-2026 strategies across Europe. As this period of exceptional public support transitions toward a more normalised investment landscape, investors must evaluate assets not only through engineering or market assumptions, but through the stability and trajectory of the regulatory environment.

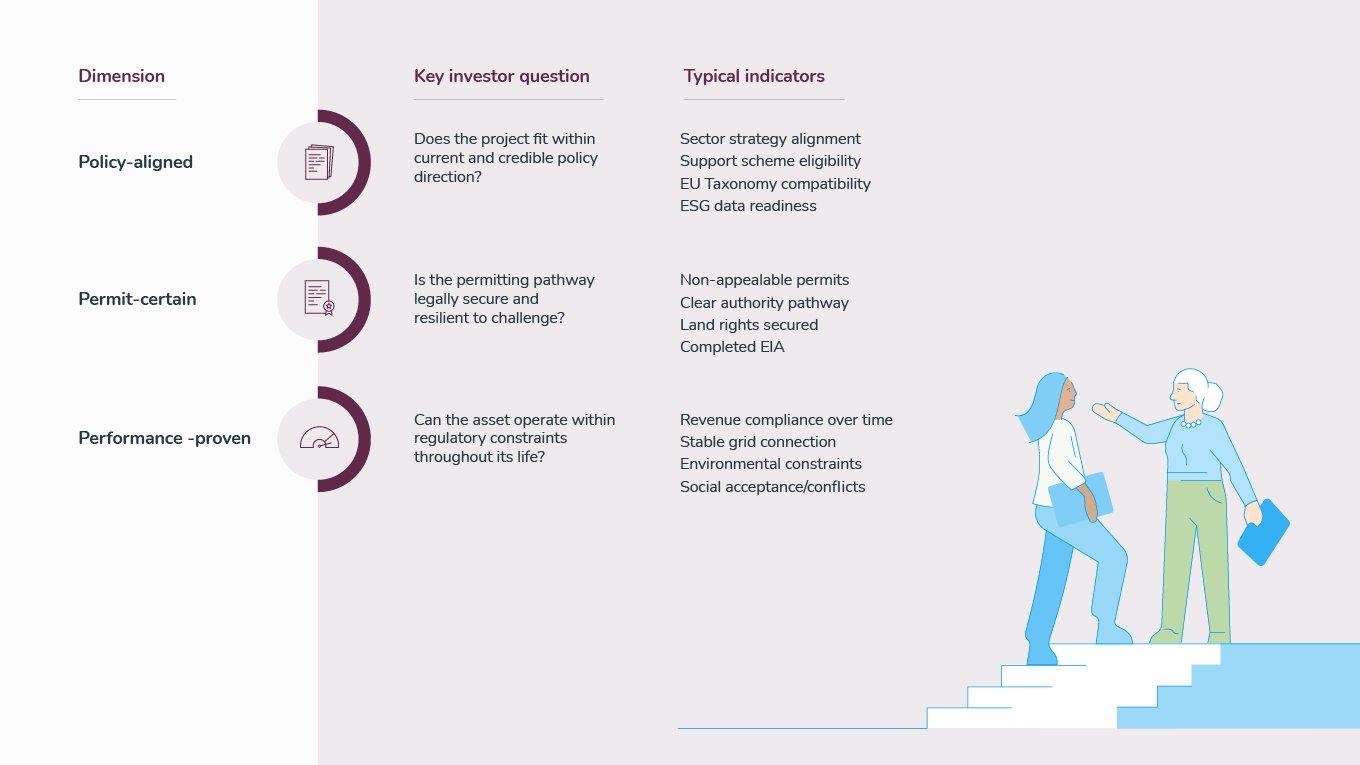

Three characteristics of investable infrastructure

In this environment, infrastructure investability is increasingly assessed through three interlinked dimensions.

  1. Policy-aligned: the project's revenue model, cost structure and disclosures are compatible with current and credible near-term policy frameworks, its taxonomy/ESG posture supports capital access and insurance, and it fits the technology‑specific acceleration toolkits available.
  2. Permit-certain: the permitting pathway is secure, legally robust, and resilient to procedural or community challenges.
  3. Performance-proven: the asset can operate within its regulatory and commercial envelope throughout its operating life.

These are not sequential stages. They interact throughout the asset lifecycle, and weaknesses in any one-dimension compound into value risk across the others.

Three characteristics of investable infrastructure
1. Assessing policy alignment

An infrastructure asset is policy-aligned when its revenues, cost structure and disclosures are resilient to current and credible near-term policy.

Policy alignment asks whether the financial model holds under policies that already exist, and whether the assets’ ESG and taxonomy posture supports capital access rather than constraining it. Projects that can demonstrate this alignment will access cheaper capital, insure more favourably, and avoid stranded asset risk as policy tightens toward 2030 and 2045 targets.

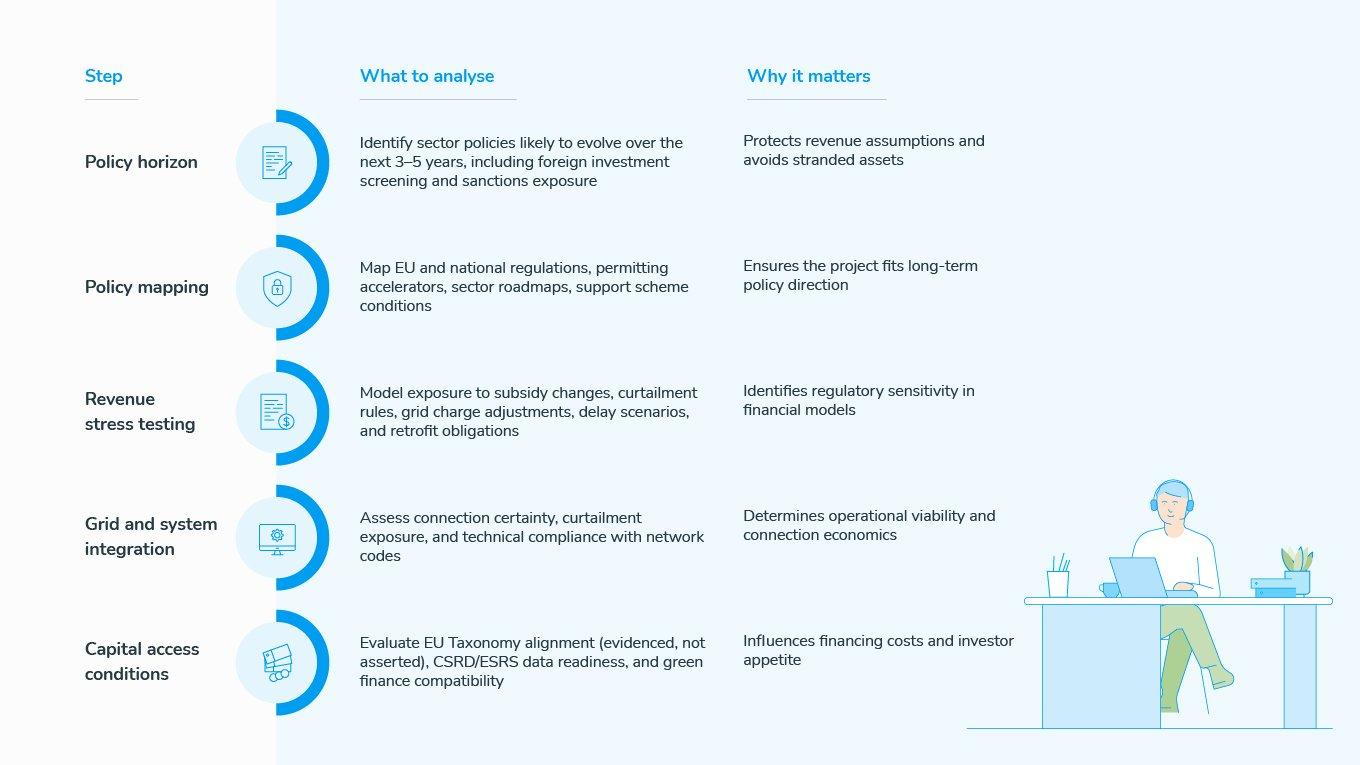

In practice, policy alignment is tested through structured analysis of policy horizons, regulatory frameworks, revenue sensitivities and financing conditions. Assets that cannot answer the following questions with evidence, not assertions, carry policy risk that is typically not priced into the transaction

PEI article graph
2. Assessing permitting certainty

Permitting remains one of the most significant sources of risk in infrastructure transactions. Project delays, legal appeals, and procedural gaps can materially affect construction schedules and financial models.

The binary view, permit obtained or not, misses the most consequential risks:

  • Conditions embedded in existing permits that may require future investment
  • Appeal windows that remain open
  • Interactions between permit conditions and evolving environmental or safety standards
  • Community or NGO opposition that can reopen what appeared to be settled approvals.

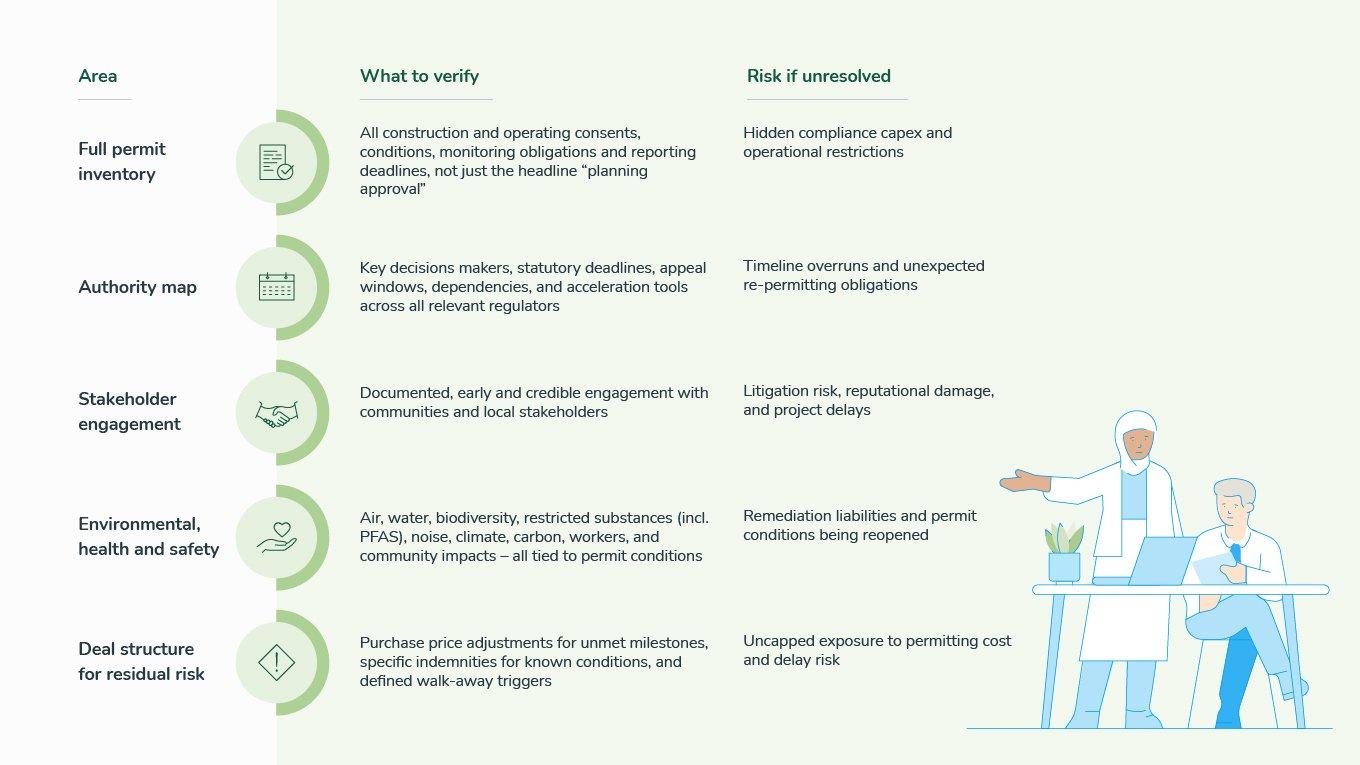

A structured permitting assessment confirms the full inventory of permits and approvals, evaluates their legal robustness, examines stakeholder and community engagement processes, and ensures that residual risk is clearly structured into the deal.

The practical test is not whether permits exist, but whether the permitting thesis can be written concisely, including the risk register, the sensitivities and the contractual protections.

Fig 2 .  Assessing permitting certainty
3. Securing long-term asset performance

Obtaining permits does not eliminate regulatory risk. A frequent assumption in infrastructure transactions is that once consents are in place, the regulatory dimension is largely resolved. This is incorrect, and the consequences of that misconception can grow over time.

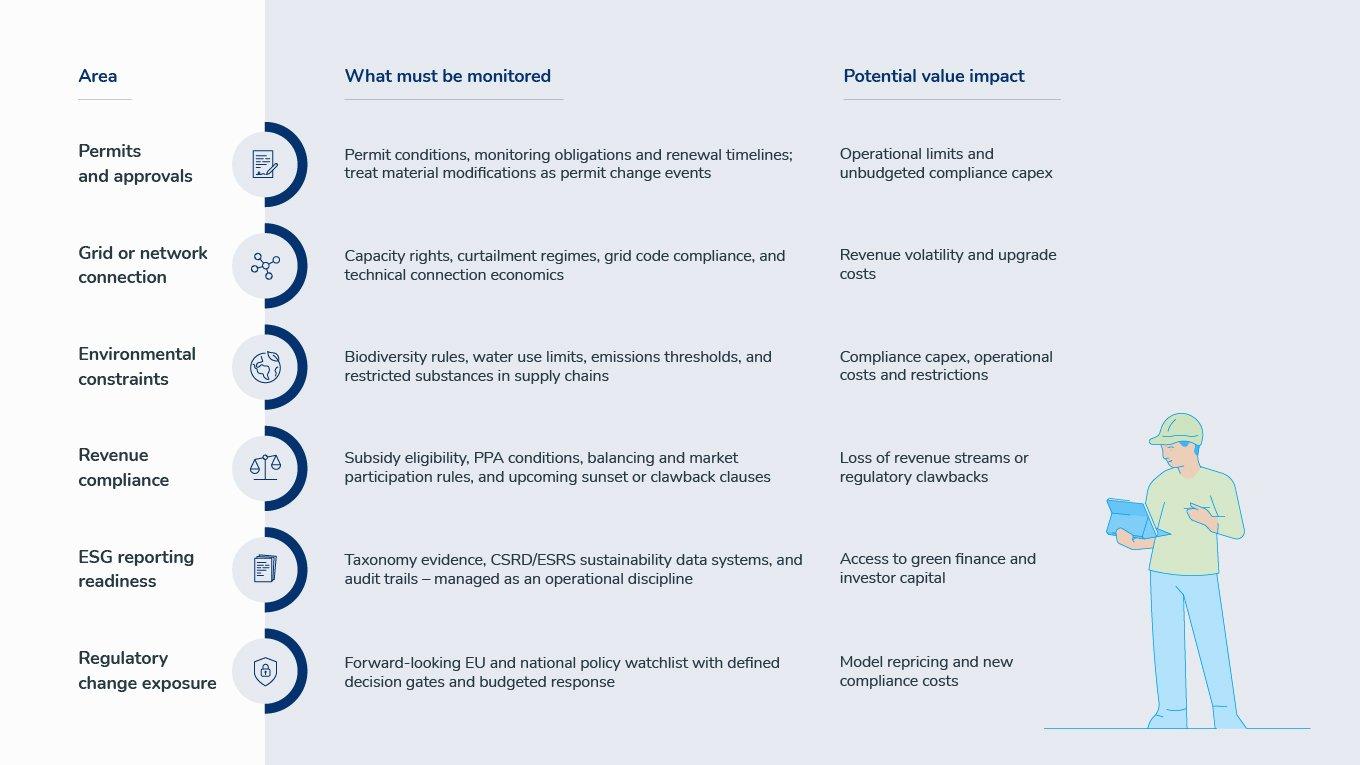

Infrastructure assets operate for decades and must adapt to evolving environmental standards, grid requirements, safety rules, and market frameworks. Permit conditions themselves create long-term operational obligations, including emissions thresholds, biodiversity protection measures, water use limits, monitoring programmes, and community commitments. These conditions can limit operational flexibility, generate recurring compliance costs and require periodic capital investment, and they interact with revenue structures and reporting duties in ways that accumulate across the asset life.

Regulatory exposure must therefore be treated as a dynamic risk factor affecting operational expenditure, capital investment and ultimately asset value. Investors benefit from managing assets within a clearly defined regulatory and commercial operating envelope, supported by continuous monitoring and pre-defined triggers for change management.

Fig.3  Securing long-term asset performance
Red flags to act on now

Across all three dimensions, the following warning signs reoccur most frequently in European infrastructure transactions and should prompt immediate scrutiny in due diligence.

  1. Revenue cases and capital structures that rely on policy assumptions not yet locked in.
  2. Incomplete permits, weak grid or network connection certainty, and assets marketed as "green" without credible EU Taxonomy alignment and supporting disclosures.
  3. Unverified assumptions about permitting acceleration, and business cases that assume permits alone will resolve environmental, social and regulatory risks over the full asset life.
Conclusion

European infrastructure investment is increasingly shaped by policy frameworks, permitting processes, and long-term regulatory dynamics. In a post-RRF market, the assets most likely to attract long-term capital and maintain stable cash flows are those that demonstrate genuine alignment across all three dimensions: policy alignment, permitting certainty, and the ability to operate within an evolving regulatory envelope throughout their lives.

Integrating these dimensions into due diligence and asset management is therefore not simply a regulatory exercise. In a policy-driven investment environment, due diligence becomes the spine connecting policy alignment and permitting certainty with long-term performance. Investors who build the discipline to assess and manage regulatory risk continuously, not only at acquisition, can price risk more accurately and structure better protections that preserve value across the full asset lifecycle.

Infrastructure that is policy-aligned, permit-certain and performance-proven is safer to own and has become the investable standard.
